Laser vs Plasma vs Waterjet Cutting for Sheet Metal

July 10, 2026

Laser vs Plasma vs Waterjet Cutting for Sheet Metal

Laser, plasma, and waterjet all cut flat metal — and all three will appear in quotes when you send a sheet metal RFQ to Asia. But they differ enormously in tolerance, edge quality, thickness range, and cost per meter of cut. This guide is for design and procurement engineers who need to pick the right process (or let the supplier pick it intelligently), understand what the choice does to part cost, and write an RFQ that doesn’t accidentally force an expensive process onto a part that doesn’t need it.

Choose fiber laser as the default for sheet metal up to about 20–25 mm in steel, plasma for thick carbon-steel plate where cost per meter outranks edge finish, and waterjet only when heat, exotic materials, or extreme thickness rule the other two out.

Key takeaways:

  • Vietnam’s verified partner facility ecosystem provides Tier-1 precision manufacturing with direct engineering transparency and relief from Section 301 Chinese punitive tariffs for qualifying goods.
  • Technical documentation must pair 3D models with 2D drawings detailing critical GD&T datums, tolerance limits, and material specs.
  • On-site supplier auditing (50-point Dolphin Audit across QCLDM) verifies machinery capacity, CMM metrology, and material traceability.
  • Sourcing through DEWIN guarantees Delaware LLC contracting, streamlined RFQ turnaround and engineering review turnaround, and door-to-door DDP logistics.

Key Takeaways

  • Fiber laser is the default for sheet metal up to ~20–25 mm in steel: fastest on thin gauge, best combination of tolerance (±0.1 mm typical) and edge quality for the price.
  • Plasma wins on thick carbon steel plate (12–50 mm) where cost per meter matters more than edge finish; expect ±0.5–1.5 mm and some dross cleanup.
  • Waterjet is the specialist: no heat-affected zone, cuts any material at any practical thickness, ±0.1–0.25 mm — but it is typically the slowest and most expensive per meter.
  • Specify requirements (tolerance, edge condition, HAZ sensitivity), not processes, in your RFQ — unless you have a real reason to lock the process in.

How Does Each Cutting Process Work?

Fiber Laser Cutting

A fiber laser concentrates a high-power beam (2–12 kW is now common in production shops) that melts and vaporizes metal while assist gas ejects the molten material. Nitrogen assist gives clean, oxide-free edges on stainless and aluminum; oxygen assist cuts carbon steel faster but leaves an oxide layer. Fiber sources have largely displaced CO2 machines in new installations because they cut thin sheet several times faster and consume less power.

Plasma Cutting

Plasma forces an electrical arc through a constricted nozzle with ionized gas, creating a jet hot enough to melt any conductive metal. Modern high-definition plasma dramatically improves on old handheld-plasma reputations, but it remains a thermal process with a wider kerf, a visible heat-affected zone (HAZ), and edge bevel of roughly 1–3 degrees. Its economics shine on thick carbon steel where laser slows down and waterjet becomes prohibitively slow.

Waterjet Cutting

An abrasive waterjet pumps water to 4,000–6,000 bar and entrains garnet abrasive, eroding through material rather than melting it. Because it is a cold process, there is no HAZ, no thermal distortion, and no change to material properties at the edge — which is why aerospace and parts destined for post-cut heat treatment often specify it. It cuts anything: hardened tool steel, titanium, glass, stone, stacked sheets.

Industrial enclosures, chassis, and formed sheet metal assemblies fabricated in Vietnam.
✔ Waterjet is a cold process with no heat-affected zone True
Because abrasive waterjet erodes rather than melts material, it leaves no HAZ, no thermal distortion, and no edge-property change — which is why heat-sensitive and post-heat-treat parts specify it.
✘ Waterjet is the best default choice for ordinary thin sheet metal False
On thin sheet, waterjet typically costs several times more per part than fiber laser for no functional benefit. It earns its premium only when heat, exotic materials, or extreme thickness demand it.

How Do Laser, Plasma, and Waterjet Compare?

This is the decision table we use when routing parts to factories:

Attribute Fiber Laser High-Definition Plasma Abrasive Waterjet
Practical thickness (carbon steel) 0.5–25 mm 3–50 mm (severance to 80+ mm) 0.5–150+ mm
Practical thickness (stainless) 0.5–20 mm 3–40 mm 0.5–150+ mm
Practical thickness (aluminum) 0.5–12 mm 3–40 mm 0.5–150+ mm
Typical tolerance ±0.1 mm ±0.5–1.5 mm ±0.1–0.25 mm
Kerf width 0.1–0.4 mm 1.5–5 mm 0.8–1.2 mm
Edge quality Excellent; minimal dross with N2 Good; slight bevel, some dross on thick plate Excellent; slight taper on thick cuts
Heat-affected zone Small (0.05–0.2 mm) Moderate (0.5–1 mm+) None
Materials Metals (reflective metals need fiber, not CO2) Conductive metals only Any material
Speed on 3 mm mild steel Very fast (benchmark) Fast, but inferior edge Slow (often 5–10× laser cycle time)
Speed on 25 mm mild steel Slow/marginal Fast — the sweet spot Very slow
Relative cost per meter (thin sheet) Lowest Low, but quality tradeoff Highest
Relative cost per meter (thick plate) High Lowest Highest
Secondary operations Rarely needed Dross removal, sometimes edge machining Rarely needed; abrasive residue rinse

Numbers are typical production ranges, not machine limits — an individual shop’s equipment and parameters will shift them.

What Drives Cost per Part and Cutting Speed?

Cutting cost is essentially (machine hourly rate × cycle time) + consumables + material, so the process choice interacts with thickness:

  • Thin sheet (≤6 mm): Fiber laser wins almost unconditionally. Cycle times are so short that even a higher hourly rate produces the lowest cost per part. Waterjet on thin sheet typically costs several times more per part for no functional benefit — unless HAZ is genuinely unacceptable.
  • Mid plate (6–20 mm): Laser and plasma converge. If the part goes on to welding and painting, plasma’s edge is usually acceptable and cheaper. If holes need to stay round for fasteners or the part is cosmetic, laser earns its premium. Note that plasma struggles with holes smaller than ~1.5× material thickness.
  • Thick plate (20 mm+): Plasma is the cost leader on carbon steel; waterjet takes over where tolerance, material (stainless, aluminum, titanium), or HAZ rules plasma out.
  • Batch size matters: Laser and plasma have near-zero per-job tooling; waterjet’s garnet consumption (often $20–$40 per machine-hour in abrasive alone) makes it expensive at any volume, so it should be reserved for parts that need it.

Also count downstream cost: a plasma-cut edge that needs grinding before welding can erase the cutting savings. Quote the full routing, not the cutting operation alone — our manufacturing cost guide covers how Vietnamese factories build up these routings.

On cost, thickness decides the winner: fiber laser is cheapest on thin sheet up to about 6 mm, laser and plasma converge from 6–20 mm, and plasma leads on carbon-steel plate above 20 mm — with waterjet reserved for parts that genuinely need a cold, HAZ-free cut.

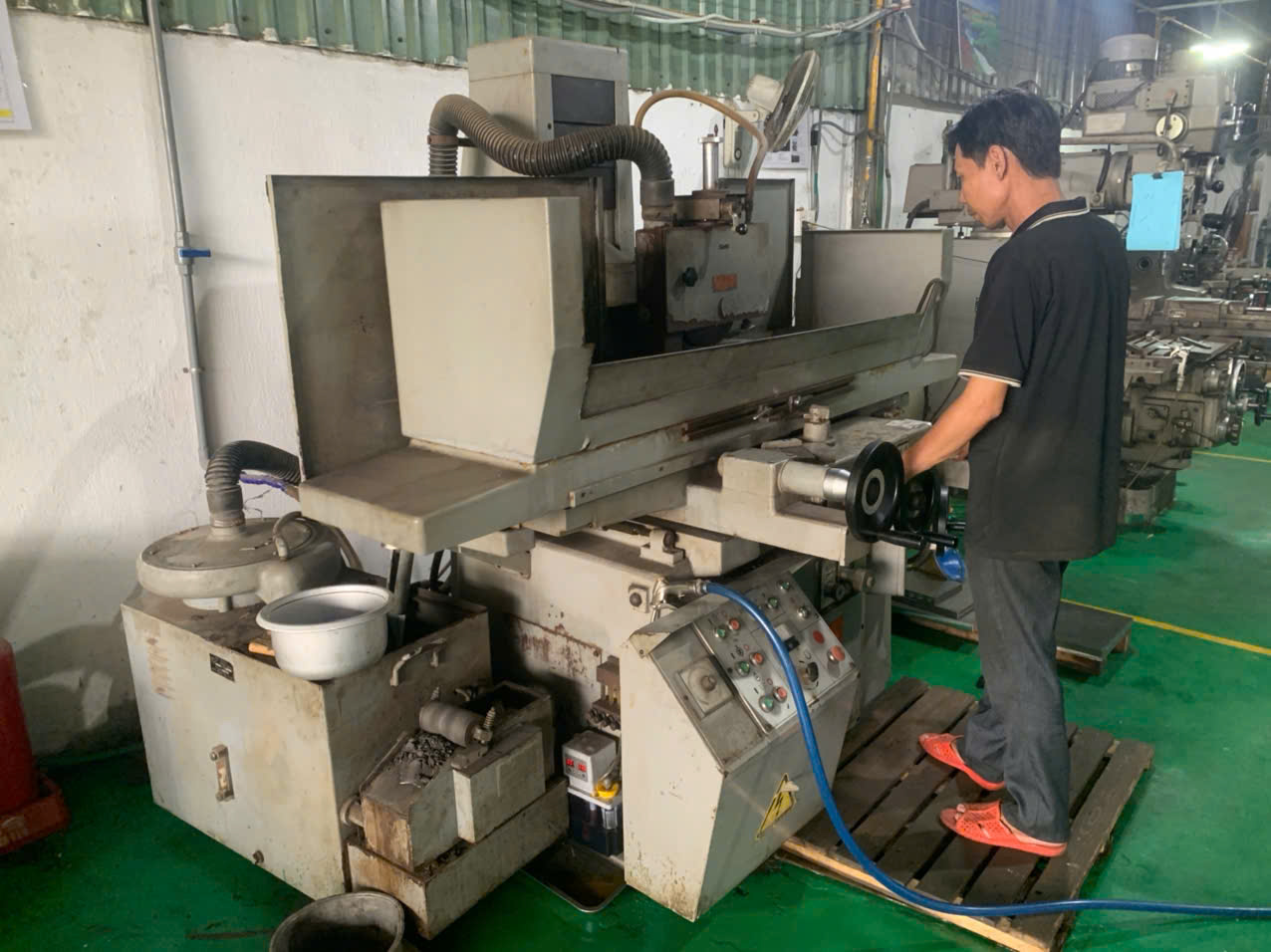

Surface grinding machine used for edge finishing at a DEWIN-verified Vietnamese supplier facility

✔ Downstream operations like edge grinding can erase a cheaper cut's savings True
A plasma-cut edge that needs grinding before welding adds labor that can outweigh the lower cutting cost, so the full routing — not the cut alone — determines the cheapest process.
✘ The cheapest cutting operation always gives the lowest part cost False
Cutting is one step in a routing. Kerf quality, dross, hole roundness, and secondary operations all feed final cost, so the lowest cut price can still lose on landed part cost.

When Should I Combine Cutting Processes?

Real products rarely use one process in isolation:

  • Waterjet + laser: Waterjet the 30 mm base plate, laser the 2 mm cover — same assembly, right tool for each part.
  • Plasma + machining: Plasma-cut thick blanks slightly oversize, then CNC-machine the critical bores and mating faces. Common for machine frames and heavy brackets.
  • Laser + bending + welding: The standard sheet metal enclosure routing — precision laser-cut blanks, CNC press brake bending, then welded and powder-coated.
  • Tube laser for structures: If your weldment uses square or round tube, a dedicated tube laser cuts copes, holes, and joints in one operation and eliminates most fixturing.

Letting one supplier coordinate the combined routing usually beats splitting POs across specialty shops, because tolerance responsibility stays in one place.

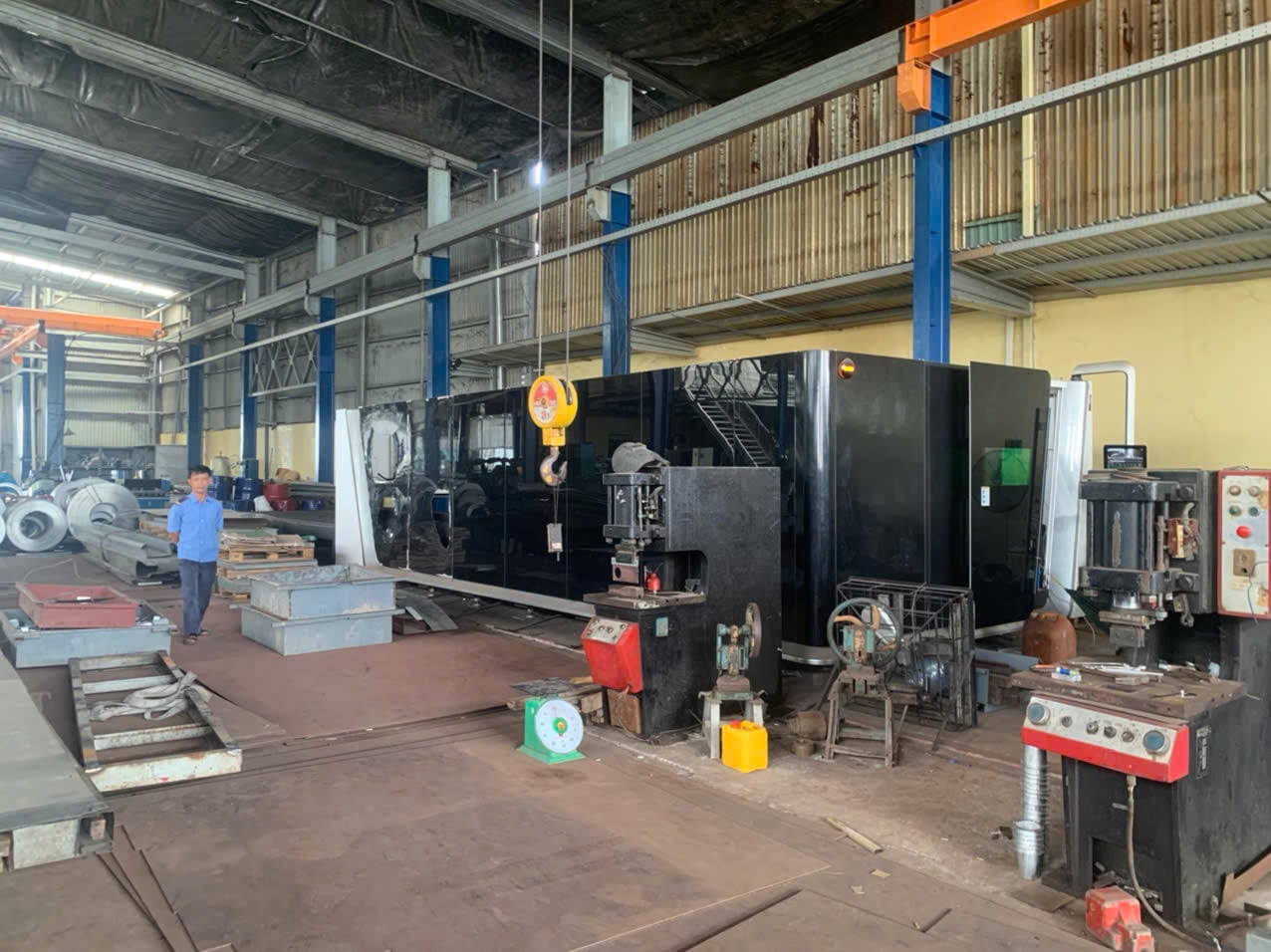

Laser cutting machine running sheet stock at An Thanh Technology, a DEWIN-verified Vietnamese supplier facility

What Does the Vietnamese Cutting Equipment Landscape Look Like?

Ten years ago, waterjet and plasma dominated Vietnamese job shops. That has flipped. Fiber lasers — Trumpf, Bystronic, Amada, and increasingly capable Chinese brands like Bodor and HSG in the 3–12 kW class — are now standard equipment in export-oriented sheet metal factories around Hanoi, Ho Chi Minh City, Binh Duong, and Dong Nai. Tube lasers and automated load/unload towers are appearing in tier-1 shops serving Samsung, LG, and their export supply chains.

In Vietnam’s export sector, fiber lasers are now the default: expect laser-quality edges and ±0.1 mm profile tolerance as the standard quote basis, high-definition plasma concentrated in structural-steel shops, and thinner waterjet capacity that should be flagged early so parts route to the right factory.

Automatic horizontal band saw cutting machine at a DEWIN-verified Vietnamese supplier facility

Practical consequences for buyers:

  • You should expect laser-quality edges and ±0.1 mm profile tolerance as the default quote basis for sheet work in Vietnam, at pricing that typically runs 20–40% below comparable China quotes before tariffs — and Vietnam-origin parts enter the US at relief from Section 301 Chinese punitive tariffs for qualifying goods.
  • High-definition plasma capacity is concentrated in structural steel and shipbuilding-adjacent factories; it is the right ask for thick mild steel weldments.
  • Waterjet capacity exists but is thinner on the ground; parts that genuinely require it should be flagged early so they route to the right factory. Within DEWIN’s network of vetted Vietnamese manufacturing facilities (each vetted with our 50-point Dolphin Audit, including equipment verification), we route by installed capability rather than by what a sales office claims. Typical cutting lead times are covered on our Vietnam manufacturing lead times guide page.
✔ Vietnam-origin cut parts enter the US at relief from Section 301 Chinese punitive tariffs for qualifying goods True
Section 301 duties apply to China-origin goods; parts cut and fabricated in Vietnam sit outside that scope, and Vietnamese sheet pricing often runs 20–40% below comparable China quotes before tariffs.
✘ Vietnamese shops still rely mainly on plasma and waterjet False
That was true a decade ago. Export-oriented factories have shifted decisively to fiber lasers, with tube lasers and automated load/unload towers now appearing in tier-1 shops.

What to Specify in Your RFQ: Checklist

Give suppliers requirements, not process lock-ins, and you’ll get the cheapest compliant routing:

  • Material grade and thickness (with acceptable substitutes, if any)
  • Profile tolerance — and which features actually need it
  • Hole size/position tolerances, and whether holes are for fasteners, dowels, or clearance
  • Edge condition: as-cut acceptable? Max burr/dross? Paint-ready?
  • HAZ sensitivity: will the part be heat treated, certified-welded, or fatigue-loaded?
  • Flatness requirement after cutting
  • Downstream operations (bending, welding, coating) so one supplier can quote the full routing
  • Volumes and batch sizes — process economics change with quantity
  • Only specify “must be waterjet/laser cut” if a real engineering constraint demands it

Ready to benchmark your part specifications with verified Vietnamese factories? Submit your 2D/3D drawings to request a custom quote or browse our verified supplier directory.
