Skid Sprayer Frame

China-to-Vietnam supply chain migration completed in 10 months

Sheet MetalWeldingSupply Chain Migration
10
Months to Complete
100%
Local Supply Chain
0%
Tariff Exposure

The Challenge

Facing international trade uncertainty, a new U.S. client needed to shift their Skid Sprayer Frame production from China to Vietnam. The key requirement: establish a fully localized supply chain — sourcing all raw materials within Vietnam — to ensure complete insulation from tariff pressures and trade volatility.

1. Understanding the Customer's Requirement

After a comprehensive analysis of the customer's drawings, technical standards, and annual demand, we immediately began selecting a Vietnam factory. The key requirement was that this factory must provide an end-to-end local Vietnamese supply chain — from raw materials to finished goods — to fully address and eliminate tariff risks.

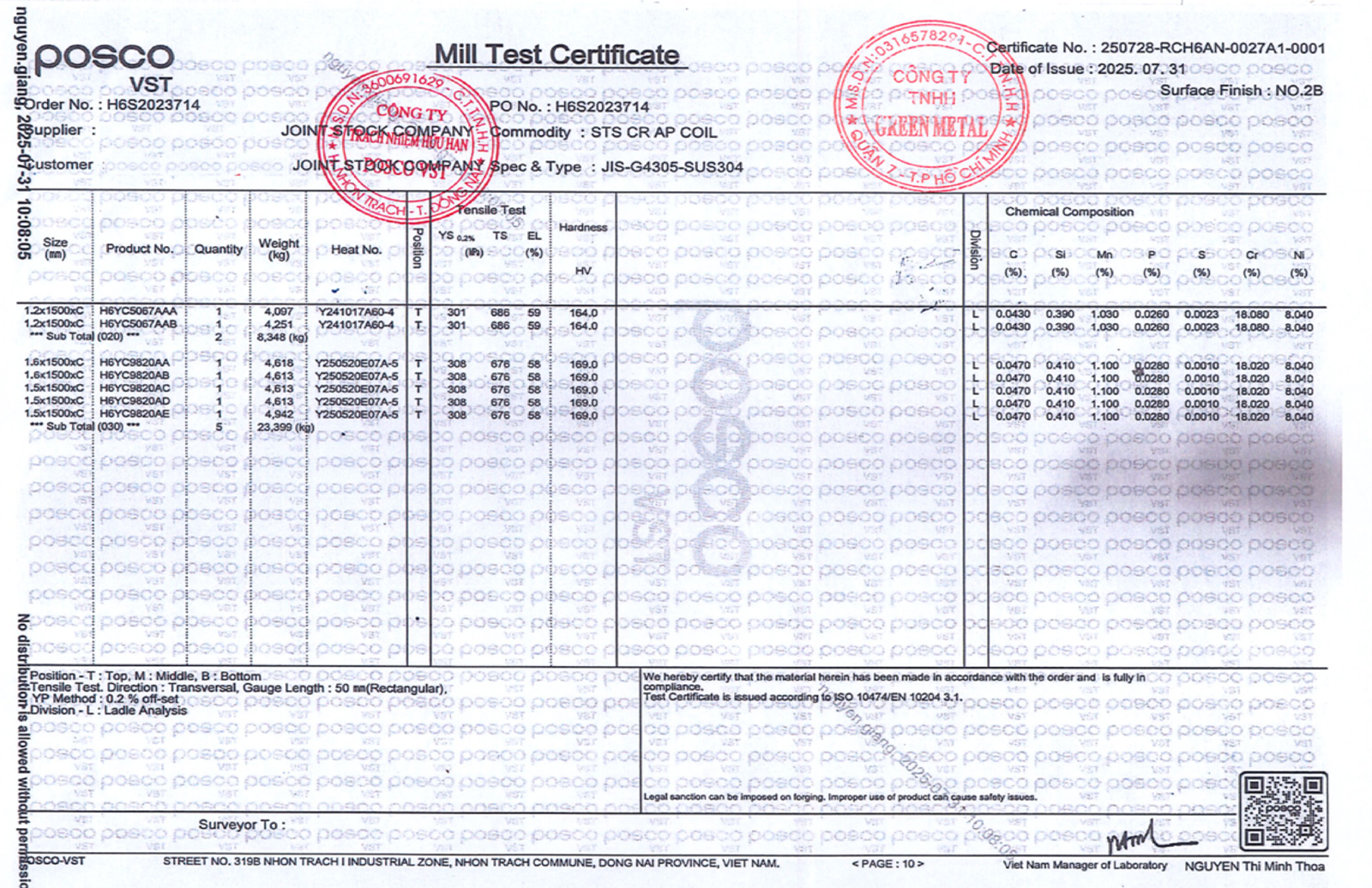

Certificate of Origin for raw materials

Certificate of Origin for Raw Materials

2. Vietnam Factory Visit & Capability Verification

Our Vietnam team visited several suppliers and finally selected one that met the customer's needs. During the on-site inspection, we checked:

  • Production capacity for cutting, welding, and machining
  • Fixture preparation and welding consistency
  • Quality-control workflow and measurement tools
  • Production stability and delivery capability

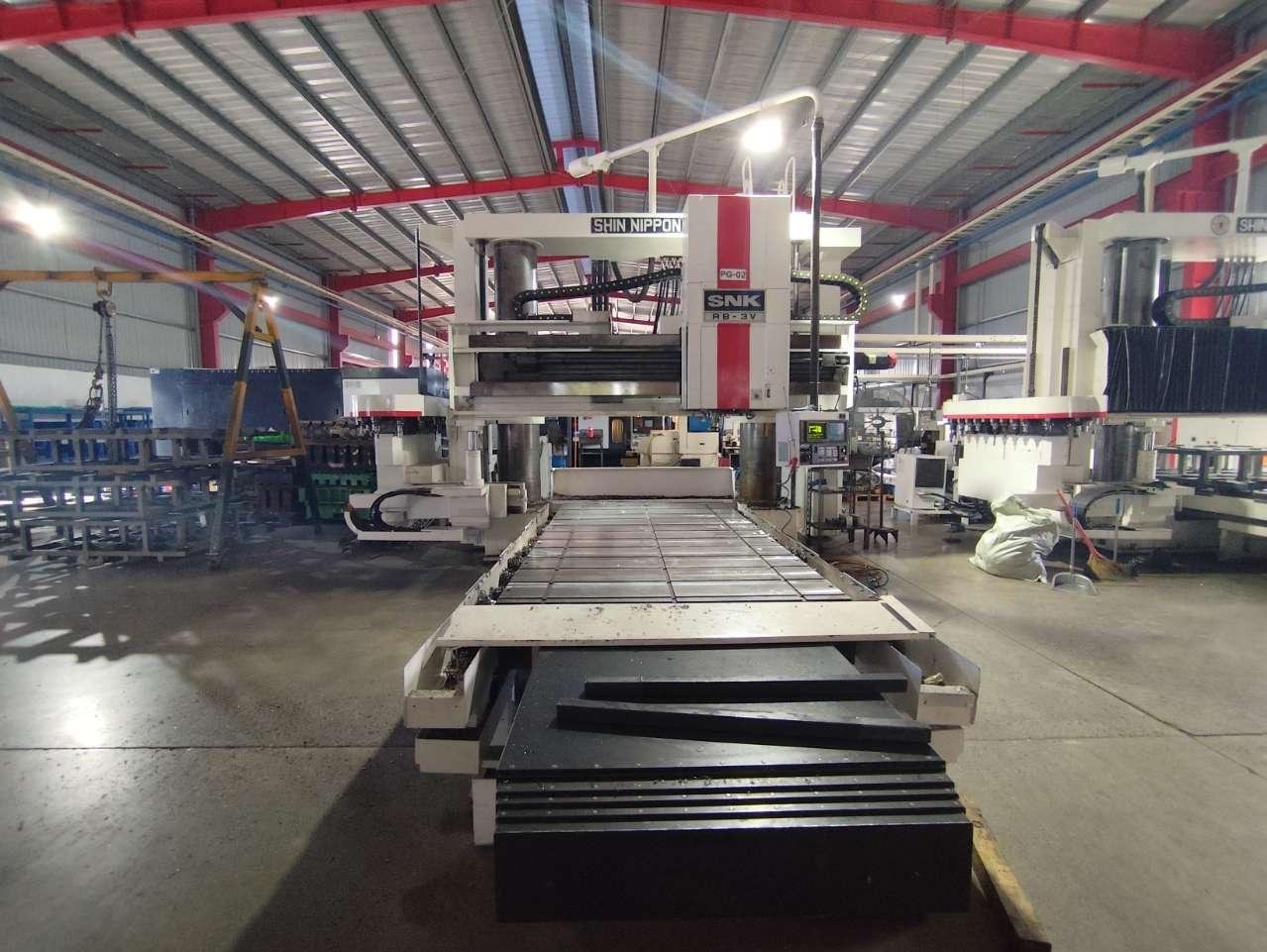

DEWIN team and customer during the factory visit in VietnamDouble-column machining center verified during the factory capability check

Watch how a factory visit works: this video from our YouTube channel shows our local sourcing team stepping inside a real Vietnamese factory — the same on-the-ground verification process used for this project.

Step Inside a Real Vietnamese Factory with Our Local Sourcing Team

Step Inside a Real Vietnamese Factory with Our Local Sourcing Team

Watch on YouTube

3. On-Site Process Follow-Up

Before samples were made, our team stayed in the factory to follow each production step closely — tube cutting, tube welding, and tube surface grinding — ensuring the factory could meet the customer's welding accuracy and dimensional requirements.

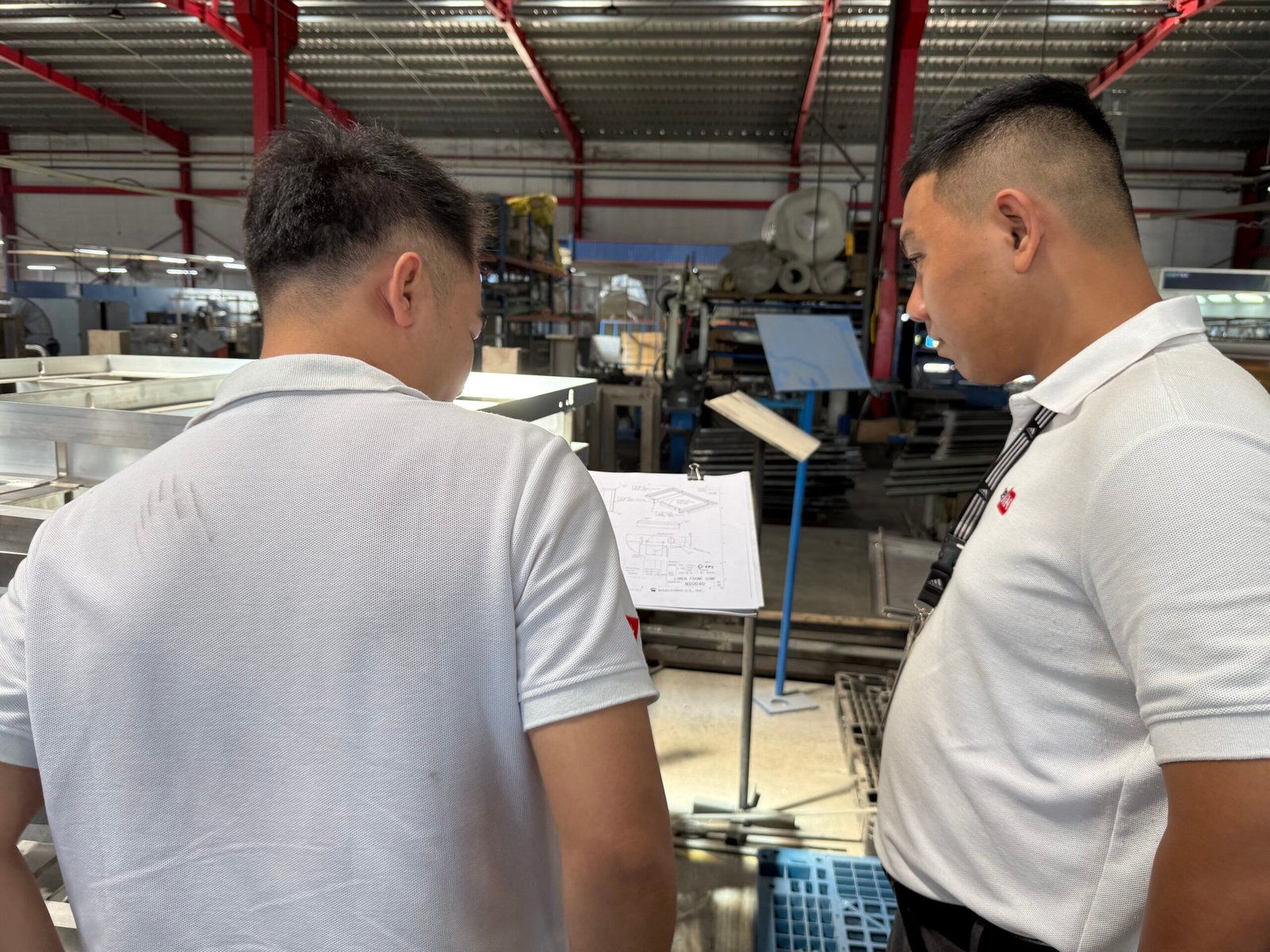

DEWIN engineers reviewing frame drawings on the factory floor

On-Site Drawing Review

Inspecting cut tube samples with the factory team

Cut Tube Inspection

Production follow-up discussion with factory staff

Process Follow-Up

4. First Sample Batch & Inspection

Once the process was confirmed, the factory produced the first samples. We carried out full inspections on welding flatness & penetration, tube alignment & dimensions, hole distance & hole-diameter accuracy, and surface grinding & finish quality.

Skid sprayer frame sample inspection

5. Mass Production & Shipment

With samples approved by the customer, the factory moved into mass production. All frames completed welding, grinding, QC checks, packing, and were ready for shipment.

Summary

This project shows how quickly a full supply-chain transition can be completed when sourcing, engineering, and on-site QC are aligned. If you're considering moving production to Vietnam or building a dual-country supply chain, we can help you evaluate factories, develop samples, and manage production from start to finish.
